2012 05 07 0855

Colorado's Finest Alternative High School Move and Renovation

  • DAG (Design Advisory Group) convened

    DAG (Design Advisory Group) convened

  • Period: to

    CFAHS Move and Renovation

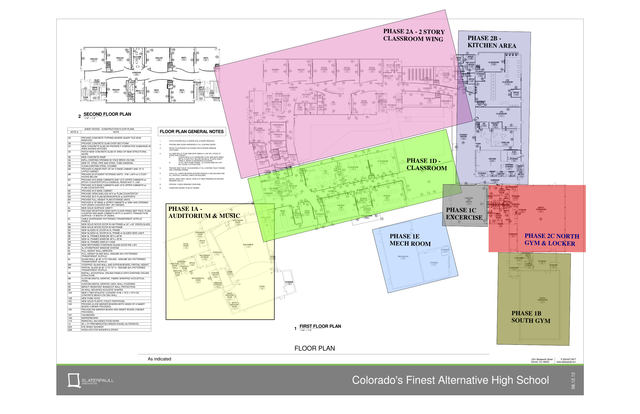

  • Phasing Plans Released

    Phasing Plans Released

  • Abatement begins in the south hallway

    Abatement begins in the south hallway

  • Phasing Plans Revised

    Phasing Plans Revised

  • Abatement plan revised

    Abatement plan revised

  • Interior design art

    Interior design art

  • Town Hall Meeting

    Town Hall Meeting

  • Abatement work continues

    Abatement work continues

  • South Wing Demo Completed

    South Wing Demo Completed

  • Ground Breaking Ceremony Scheduled

    Ground Breaking Ceremony Scheduled

  • South wing framing

    South wing framing
