-
Construction begins
-
Bridge opens to traffic
-
Tolls set at $1.30 for car and driver, and 30 cents for each passenger
-
Tolls set at a flat $1.50 per car
-
Bridge named in honor of William A. Bugge
-

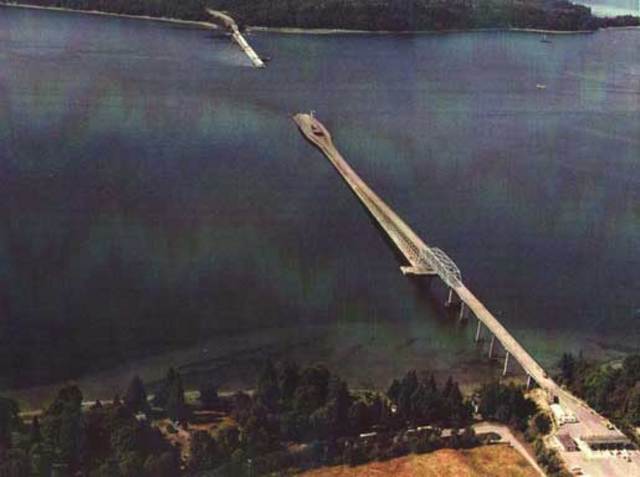

West half of bridge sinks during a storm carrying wind gusts of 120 mph and sustained winds of 85 mph
-
West-half retrofit project begins
-
Rebuilt west half opens to traffic; tolls set at $2.50
-
Tolls reduced to $2
-
Tolls removed
-

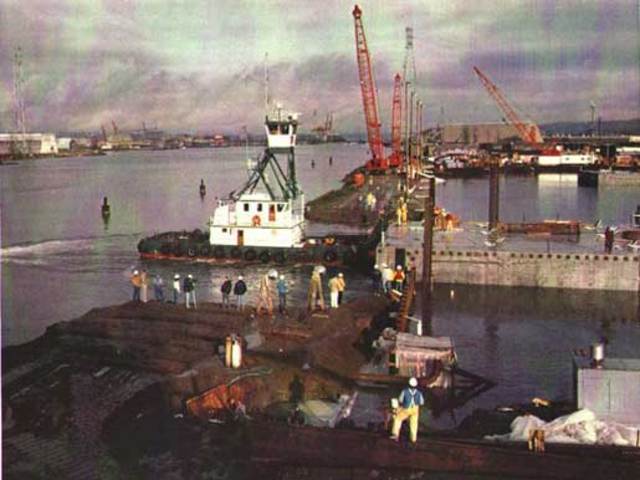

East-half replacement project begins
-
Work starts on building a graving dock in Port Angeles
-
South side of the west half of bridge widened
-
Work stops in Port Angeles after archaeological discoveries. Seattle Times reports Finding Indian remains may sink bridge project
-

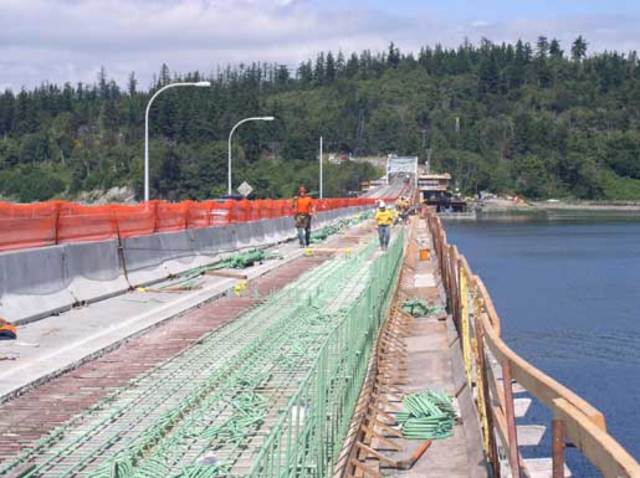

North side of the west half widened
-
State Legislature provides $471 million toward east-half replacement and west-half retrofit
-
West approach span replaced
-
East approach span replaced
-
Pontoon construction starts at Concrete Technology in Tacoma
-
State agrees to donate Port Angeles graving site to Lower Elwha Klallam Tribe, rebury all remains uncovered and pay $2.5 million in damages
-
Anchor construction begins at Todd Shipyards in Seattle
-

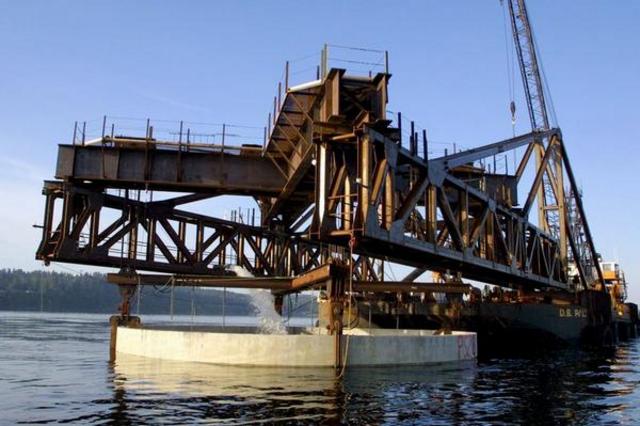

First 10 anchors placed on Hood Canal floor Read about the anchor construction
-
Second 10 anchors placed on Hood Canal floor
-
West transition truss arrives in Gamble Bay
-
West transition truss completed at Oregon Iron Works in Vancouver, Wash.
-
Final concrete pour for new pontoons at Concrete Technology Corporation in Tacoma
-
Bridge closes for six weeks as old pontoons cut away and new pontoons floated in and connected. Follow updates on the construction and closure
